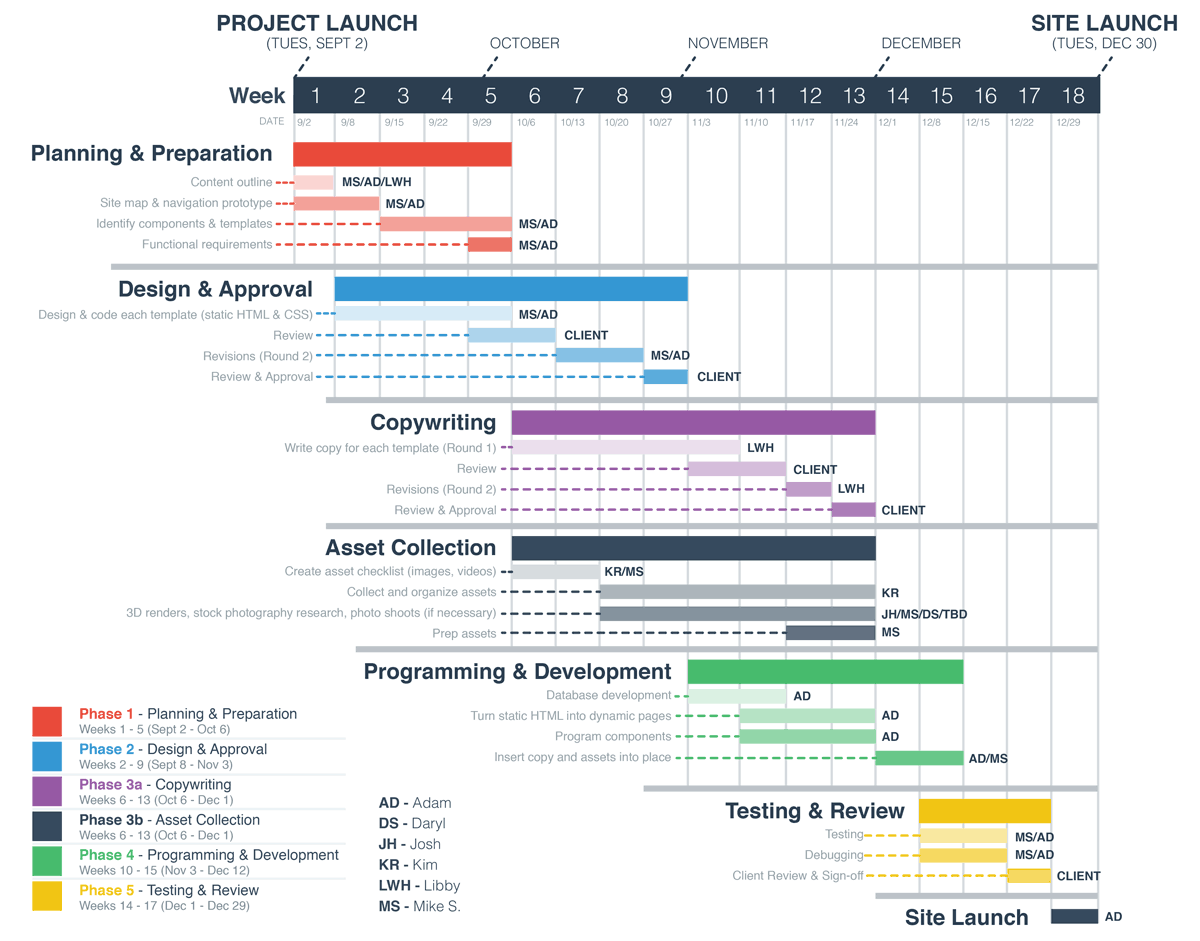

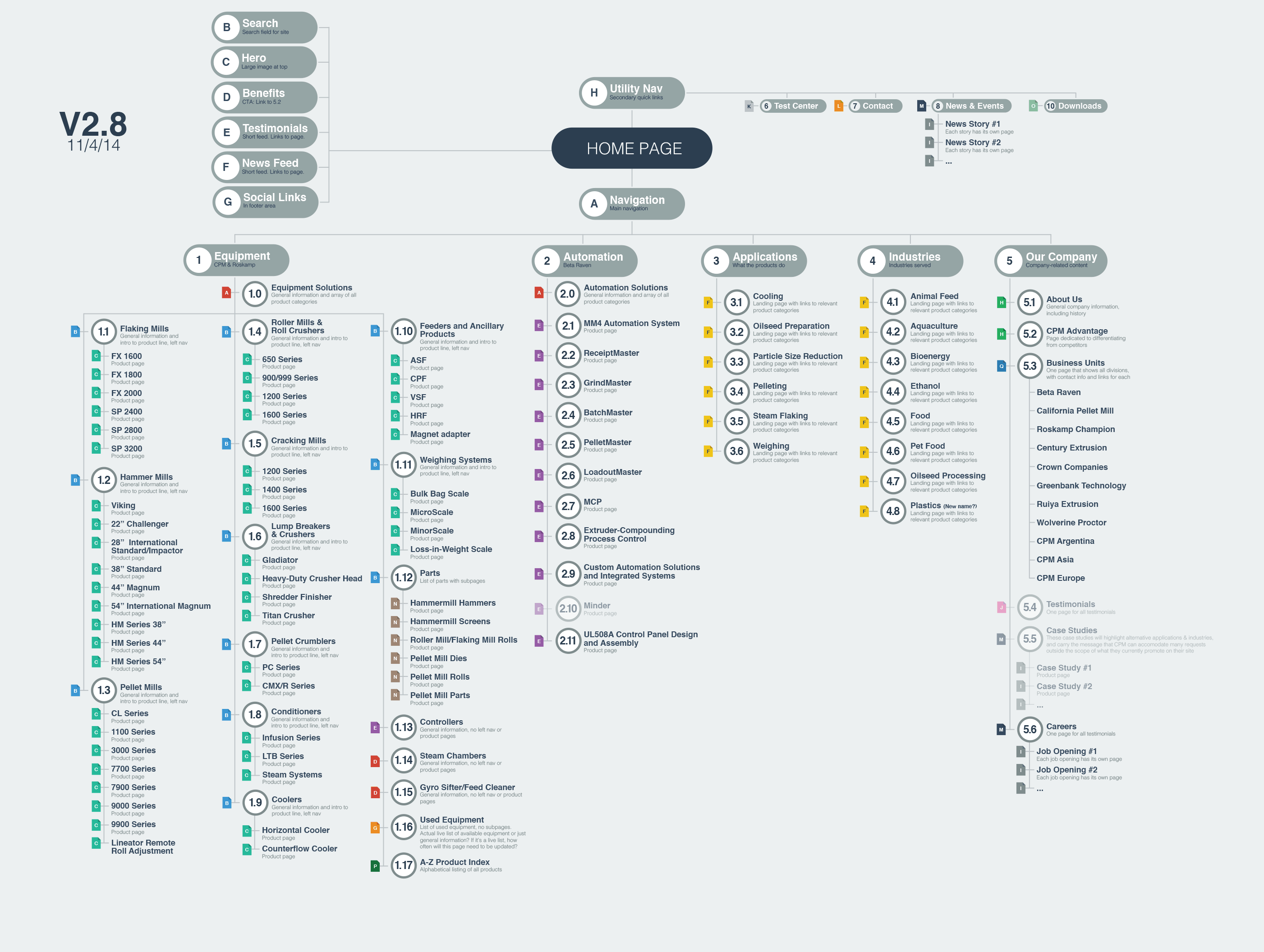

These samples were done in conjunction with this website. I was asked to determine milestones and deadlines for a large website project. My goal: help everyone visualize what steps to take (and in what order) as well as define which tasks depended on the completion of others. The site map was used to determine how many page templates we needed to create. Both of these items proved incredibly useful as we navigated through the development process.
